Moving an FPC from prototype to production requires deliberate manufacturing considerations that go far beyond simply ordering larger quantities. An FPC that performs flawlessly in a 10–50 piece prototype run can suddenly deliver low yields, dimensional drift, coverlay voids, or assembly failures once volume begins. Flexible circuits behave differently under repeated heat, pressure, and handling than rigid boards, so process windows that work at low volume often collapse at scale.
Highlights
• Prototype shops optimize for speed and design flexibility; volume fabs optimize for repeatability, statistical process control, and cost.
• Early formal DFM with the production fabricator, correct tooling decisions, and pilot-run validation prevent most scaling failures.
• Material standardization, panel nesting efficiency, and shared cost/lead-time planning with the supplier deliver the largest gains in both unit cost and schedule.
In this guide you will see exactly why the transition is uniquely difficult for flexible circuits, how to apply a practical DFM checklist, when soft versus hard tooling makes sense, which cost and lead-time levers actually move the needle, and a clear readiness framework so you can decide whether your design is ready for volume.
Why FPC Prototyping and Mass Production Are Fundamentally Different
Prototype runs exist to prove electrical function, mechanical fit, and basic reliability. The fabricator accepts material substitutions, manual stiffener attachment, flying-probe testing, and laser or soft-tool outline cutting because speed and design change tolerance matter more than unit cost. Mass production demands a stable process window, lot-to-lot material traceability, high panel utilization, automated stiffener placement, bed-of-nails or fixture testing, and hard tooling so that every board leaving the line meets the same dimensional and reliability targets.

The root causes of the gap are simple. Prototype shops are organized around rapid CAM, flexible process recipes, and low fixed overhead. Volume fabs invest in SPC, dedicated fixtures, and process parameters tuned for thousands of cycles. Material behavior that is invisible at low volume becomes visible at scale: Prototype-to-production scaling often exposes dimensional changes caused by moisture conditioning, lamination, thermal cycling, and material mismatch; adhesive flow under repeated lamination pressure creates squeeze-out or voids; coverlay registration tolerance that was acceptable on a laser-cut panel fails when a steel-rule die or progressive tool is used.
Common failure modes that appear only at volume include adhesive squeeze-out under stiffeners, coverlay voids at pad edges, progressive dimensional drift after reflow, and flex-to-install cracking caused by residual stress from unbalanced copper or asymmetric coverlay. These are not random defects—they are the predictable result of treating a production process as a larger version of the prototype process.
FPC DFM Checklist Before Moving Into Production
DFM is the highest-leverage activity before tool release. A formal review with the chosen production fabricator, ideally before the design is frozen, catches the issues that later become expensive respins. Organize the review around these practical groups.

Stack-up and material selection
Specify consistent polyimide thickness across lots, choose acrylic or epoxy adhesive deliberately, and select RA copper for dynamic flex or ED copper only when cost and static applications allow. Coverlay versus flexible soldermask must be decided early, since coverlay remains the reliability standard for dynamic or high-temperature use, while soldermask can reduce cost on static consumer parts. At volume, lot-to-lot material variation that was tolerable in prototypes drives yield loss and impedance drift.
Dimensional and tolerance rules
Minimum bend radius must be set relative to finished thickness. Coverlay opening-to-pad clearance, stiffener-to-pad registration, and overall length/width tolerances must include the fabricator’s measured material shrinkage factors. Ignoring shrinkage produces parts that no longer fit the mechanical housing after multiple thermal cycles.
Panelization and tooling design
Panel layout and tooling features must work together so the boards can move smoothly through automated assembly. Break-tab strength needs to hold the array together during processing yet separate cleanly without tearing the flexible material. The choice between routing and punching depends on volume and outline complexity. Laser or soft tooling is fine for low quantities, while punching dies become the practical option once volumes rise and edge consistency matters.
Fiducials and tooling holes must be positioned so assembly equipment can locate the panel accurately every time. Prototype panels usually keep generous borders and lower density because speed and design changes matter more. Production panels aim for higher material utilization while still providing the mechanical stability and correct tooling features needed for SMT carriers. Poor nesting wastes material and can easily double the unit cost, even when the circuit design itself is sound.
Stiffener and mechanical features
FR4, polyimide, or stainless-steel stiffeners require defined attachment methods. PSA for prototypes, thermal-bond or thermosetting adhesive for volume. Selective windows and keep-out zones near bend areas must be documented. Manual attachment that works for 20 pieces becomes a bottleneck and a source of registration error at 5,000 pieces.
Electrical and reliability requirements
Controlled-impedance feasibility must be confirmed against the volume process window, not only the prototype stack-up. Via fill or tenting decisions affect both reliability and cost. Dynamic flex cycle life should be validated on production-intent materials and processes, not only on prototype coupons.
Testability and assembly
Probe-pad accessibility, component keep-out near bend areas, and the need for carrier panels or vacuum fixtures must be designed in. SMT on unsupported flex produces tombstoning and placement errors that flying-probe testing will never catch.
|
DFM Area |
What to Review |
Production Risk |
|---|---|---|
|
Stack-up & Materials |
PI, copper, adhesive, coverlay |
Yield and impedance variation |
|
Dimensions & Tolerances |
Shrinkage, registration, bend radius |
Fit and registration failures |
|
Panelization |
Nesting, tooling holes, fiducials |
Higher unit cost |
|
Stiffeners |
Material, adhesive, placement |
Bonding and registration issues |
|
Reliability |
Flex cycles, thermal cycling |
Field failures |
|
Assembly & Test |
Carriers, probe access, fixtures |
Placement and test defects |
How Materials and Process Windows Change at Production Volume
Polyimide absorbs moisture and exhibits higher CTE than copper. In short prototype cycles the effect is small; in continuous volume lamination the cumulative dimensional change requires artwork scaling and tighter incoming material control. RA copper provides superior flex life but etches differently from ED copper, so etch uniformity and surface treatment must be locked. Coverlay remains preferred for most dynamic and high-reliability applications; flexible soldermask can be cost-effective only when the application is purely static and the volume justifies the process qualification.
Flex PCB Tooling and Fixture Strategy for Volume Production
Prototypes rely on laser cutting or low-cost steel-rule dies. Volume production almost often requires additional tools: outline dies, coverlay cutting dies, stiffener punching dies, custom test fixtures, and carrier panels or vacuum fixtures for automated SMT.
For pilot runs and designs that are still evolving, soft tooling, such as laser cutting or simple steel-rule dies, is usually enough. Hard tooling only becomes necessary when yearly volume is high enough to recover the investment, when outline tolerances are tight, or when cleaner edges and faster cycle times are required. Steel-rule dies can typically be ready in a few days to two weeks. Hard progressive dies take longer, often several weeks, and cost more, but once in place they deliver the consistency and throughput that sustained production needs.
Once hard tooling is cut, design changes become expensive. That is why critical dimensions must be frozen early. At the same time, clarify with the fabricator who owns the tools, where they will be stored, how they will be maintained, and what happens if production ever needs to move. In production, AIVON engineers evaluate carrier and fixture requirements together with the flexible PCBs panel design, particularly when thin flex circuits must enter SMT and reflow processes. The goal is to stabilize the panel before assembly rather than compensate for unsupported flex during placement. Thin flexible circuits simply will not stay flat and clean through SMT and reflow without them.
How to Reduce FPC Production Cost and Lead Time
Total cost at volume comprises material, process steps, yield loss, tooling amortization, testing, and logistics. The practical levers that reduce both cost and lead time without sacrificing reliability are:
● Standardize polyimide and copper constructions early and qualify dual sources.
● Improve panel utilization through collaborative nesting rather than accepting the prototype layout.
● Consolidate process steps, for example, combining certain stiffener and coverlay cycles, where process windows allow.
● Move from 100 % flying-probe testing to a mix of AOI plus sample or fixture electrical test once the process is stable.
● Plan safety stock for long-lead materials.
● Qualify a second-source fabricator in parallel so capacity or disruption risk is managed.
A realistic timeline from design freeze to first production lot for a medium-complexity flexible circuit is typically 6 to 12 weeks, covering tooling, pilot builds, and qualification. At AIVON, standard prototype builds ship in 9 to 12 days, while volume production lots are typically completed in about 14 to 20 days once the process is fully set up.
Each DFM or tooling decision that is deferred lengthens the overall window; each one closed early shortens it. Avoid false economies. The cheapest material or lowest quoted unit price is not necessarily the lowest total cost if it later causes yield loss, delays, or field failures.

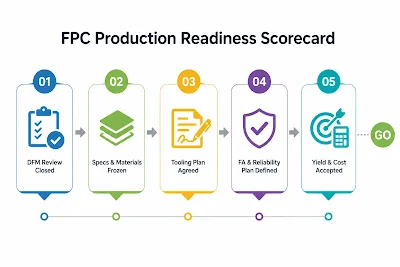

FPC Production Readiness Checklist
Use these gates as a go/no-go scorecard:
1. Formal DFM review with the production fabricator is complete and closed.
2. All critical tolerances, materials, and stack-up details are frozen.
3. Tooling strategy and ownership are agreed in writing.
4. First-article and reliability qualification plan is defined.
5. Yield target and cost model are accepted by both engineering and procurement.
Run a pilot of appropriate size against the success criteria before full ramp. Late design changes should be evaluated against tooling impact and schedule; minor ECOs can sometimes be absorbed, but major changes usually require new tools or process re-qualification.
How AIVON Supports FPC Prototype-to-Production Scaling
In one recent project, a customer submitted a panel layout designed with rigid-board rules. After the first prototype run, the flexible boards broke frequently during handling and depanelization because the connecting tabs were too weak and the process borders were insufficient.
AIVON's engineering team reviewed the panel design as part of the standard DFM process for production readiness. We recommended adding 3 mm process borders on both the left and right sides of the panel so that stronger connecting tabs could be placed on both sides. The revised panel maintained good material utilization while providing the mechanical stability needed for automated handling and SMT carriers.
After the updated panel was implemented, breakage during processing disappeared and assembly yield improved.This type of early, detailed feedback is typical of how AIVON works with customers throughout the prototype-to-production journey. From the first design review, our engineers focus on identifying issues that only become critical at volume, such as panelization strength, tooling feasibility, material consistency, and assembly handling. We treat the prototype stage as the starting point for production process definition, not a separate activity. This approach helps customers avoid unexpected yield drops, dimensional problems, and schedule delays when quantities increase, while keeping communication clear and technical decisions practical.
Conclusion
Successful transition of an flexible PCBs from prototype to production is a managed engineering process, not a simple quantity increase. The three highest-impact actions remain rigorous joint DFM, timely and appropriate tooling decisions, and shared cost and lead-time planning with the fabricator. When these elements are addressed early, yield stays high, unit cost falls predictably, and product launch schedules hold. Request a production-readiness DFM review with your fabricator before the next design freeze so the path from prototype to reliable volume is clear and controlled.
FAQs
Q1: How early should hard tooling be ordered for flexible PCB volume production?
A1: Hard tooling should be ordered only after the design is frozen and the pilot build has been successfully validated. Soft tooling or laser processing is generally more suitable during the prototype and pilot stages. Because hard tooling can require several weeks to manufacture, the order should be placed early enough to ensure the tools are ready before the first production lot is scheduled.
Q2: Which DFM rules are most commonly missed on flexible circuits?
A2: Commonly missed DFM requirements include insufficient bend-radius margins relative to finished thickness, coverlay opening-to-pad clearances that do not account for registration tolerance, unbalanced copper or asymmetric coverlay that can cause warpage, and missing or poorly positioned fiducials and tooling holes for automated assembly.
Q3: Can the same polyimide material used in prototypes be used for mass production without requalification?
A3: Only when the same material grade, thickness, copper type, and adhesive system are maintained using the same or dual-qualified suppliers, and the volume manufacturing process window has been validated. Material lot-to-lot variation that is not apparent during prototyping can affect dimensional stability, impedance, and overall production consistency at scale.
Q4: How do stiffener attachment methods change between prototype and volume FPC runs?
A4: Prototypes commonly use pressure-sensitive adhesives and manual stiffener placement for flexibility during development. Volume production typically uses thermosetting or thermal-bond adhesives with automated or semi-automated placement under controlled heat and pressure. This improves registration accuracy, process consistency, and long-term bond strength.
